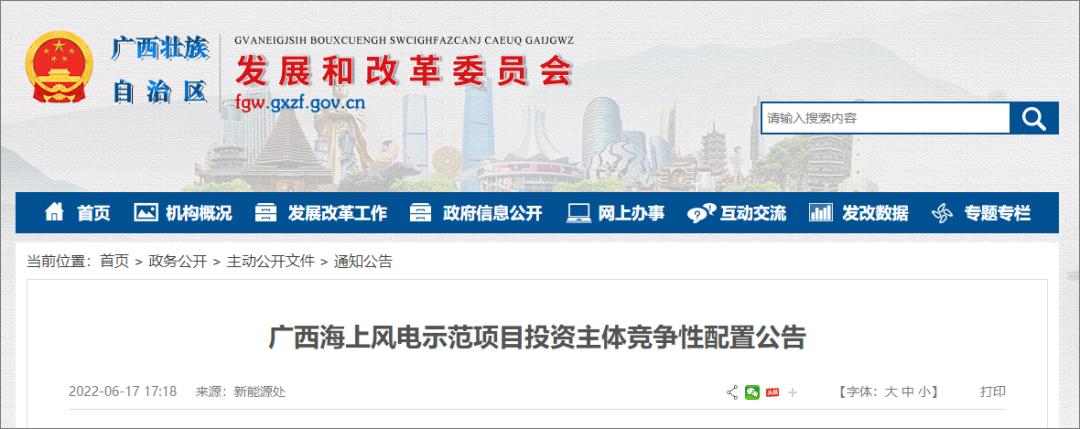

Recently, the National Energy Administration approved the sites A, F1, F2, C1, and C2 in the Guangxi offshore wind power planning site, with a planned installed capacity of 2.7 million kilowatts, which is divided into two projects: Fangchenggang Offshore Wind Power Demonstration Project and Qinzhou Offshore Wind Power Demonstration Project. . Among them, the Fangchenggang Offshore Wind Power Demonstration Project includes the planned A, F1, and F2 sites, with a planned installed capacity of 1.8 million kilowatts. The submarine cable is planned to land in Fangchenggang City; the Qinzhou Offshore Wind Power Demonstration Project includes the planned C1 and C2 sites, and the planned installed capacity is With a total capacity of 900,000 kilowatts, the submarine cable is planned to land in Qinzhou City.
In order to thoroughly implement the national strategic deployment of carbon peaking and carbon neutrality, and accelerate the construction of a strong marine area, according to the "Notice of the National Energy Administration on Matters Related to the Development and Construction of Wind Power and Photovoltaic Power Generation in 2021", Guangxi Zhuang Autonomous Region Development and Reform Commission commissioned As a third-party service agency, the General Institute of Hydropower and Water Conservancy Planning and Design organizes the competitive allocation of investment entities for Fangchenggang Offshore Wind Power Demonstration Project and Qinzhou Offshore Wind Power Demonstration Project. This competitive allocation work is carried out in accordance with the concept of "demonstration and guidance, first-in-test; technical support, scientific and reasonable; scale development, driving the industry; industrial integration, cost reduction and efficiency increase", and enterprises with the qualifications are welcome to apply.
The announcement clarifies that the applicant for investment should undertake to realize grid connection within 3 years after the project is approved, and obey the unified project plan sent by the autonomous region.
Project Overview
Fangchenggang Offshore Wind Power Demonstration Project: including the first and second phases, the first phase is 700,000 kilowatts for site A and 200,000 kilowatts for F1-1 site within the jurisdiction of the autonomous region, with a planned installed capacity of 900,000 kilowatts; the second phase of the project , that is, the F1-2 site is 350,000 kilowatts and the F2 site is 550,000 kilowatts within the state-managed sea area. The planned installed capacity is 900,000 kilowatts, and there are two sub-projects. The area of site A is about 99 square kilometers, the offshore distance is about 15-18 kilometers, and the sea depth is about 18-25 meters; the area of F1 and F2 sites is about 153 square kilometers, and the offshore distance is about 32-51 kilometers. The sea depth is about 24-31 meters.
Qinzhou Offshore Wind Power Demonstration Project: including the C1 site of 550,000 kilowatts and the C2 site of 350,000 kilowatts within the jurisdiction of the autonomous region, with a planned installed capacity of 900,000 kilowatts. The C1 and C2 sites have an area of about 129 square kilometers, the offshore distance is about 10-35 kilometers, and the sea depth is about 10-20 meters. Keywords: engineering construction, engineering news, engineering construction information
time and place arrangement
Competitive profile claim dates are June 20, 2022 - June 24, 2022. This competitive profile is applied online. The date and place of submission of application documents: July 15, 2022, 9:00-12:00; Guangxi Zhuang Autonomous Region Development and Reform Commission, 111 Minzu Avenue, Qingxiu District, Nanning City -1, East Building, Development Building. Editor/Zhao E
