Wind power
The foundations of 15 wind turbines in Julongliang, Yunnan have all been poured
Seetao 2023-03-23 17:48
  • The Julongliang wind power project has an average altitude of 3,300 meters and an installed capacity of 100MW
  • After the project is completed, it is estimated that the annual power generation will be 380 million kwh, and the annual standard coal savings will be 91,100 tons
Reading this article requires
16 Minute

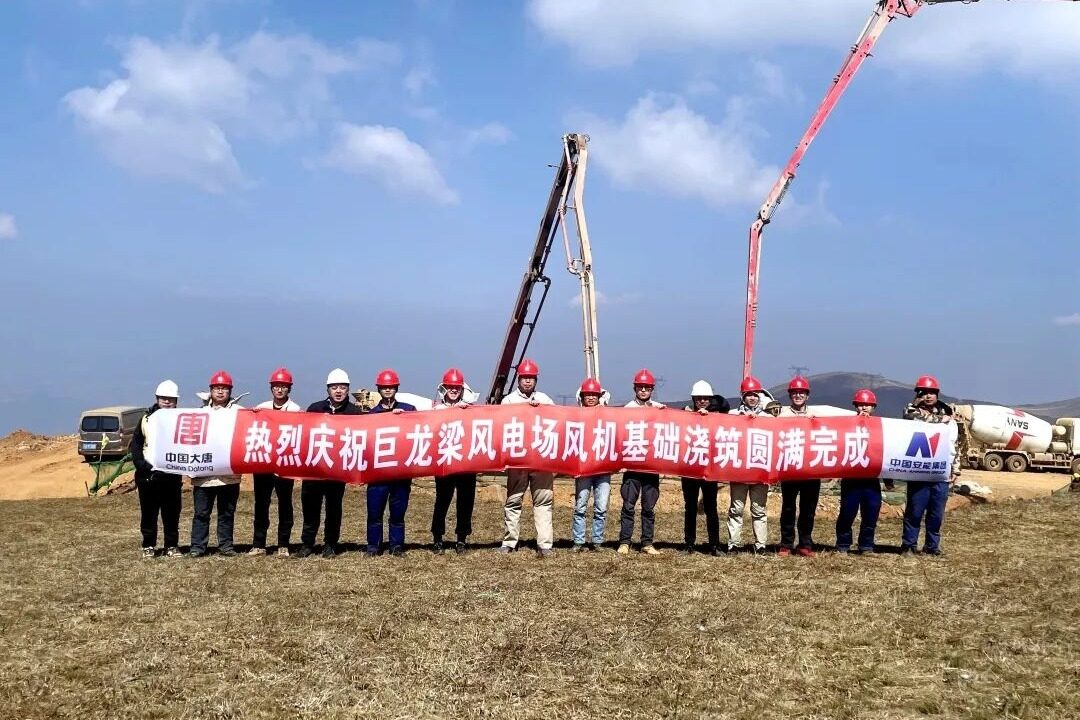

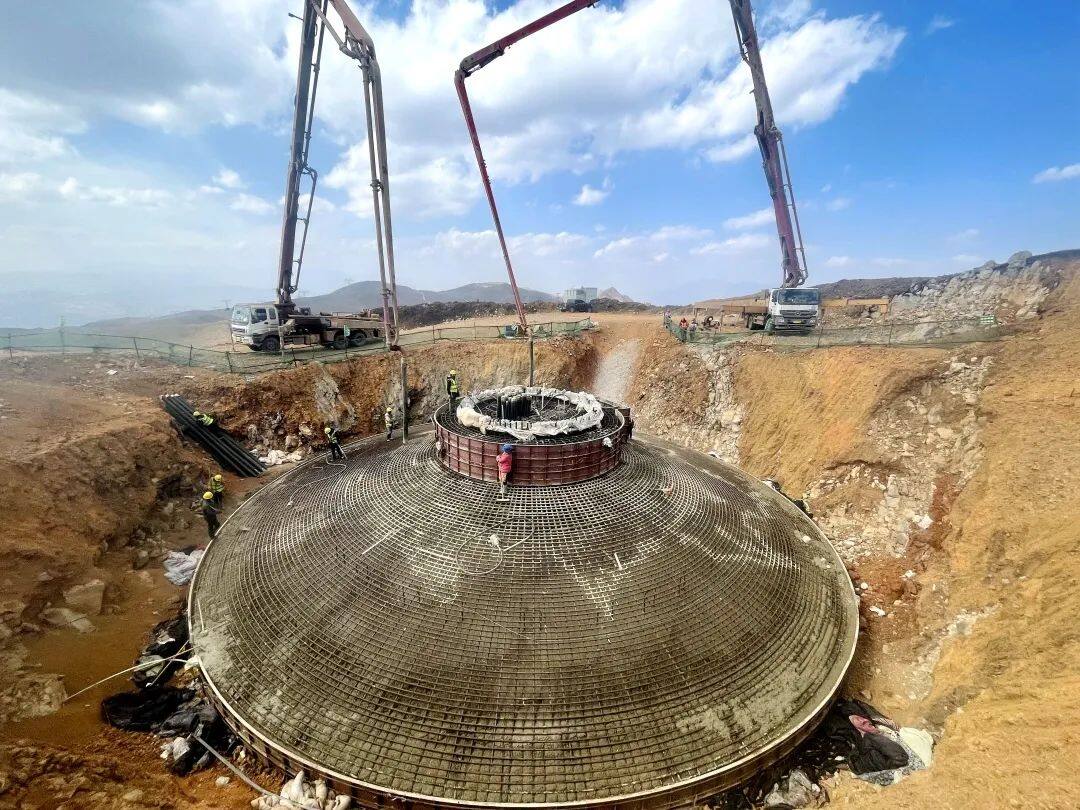

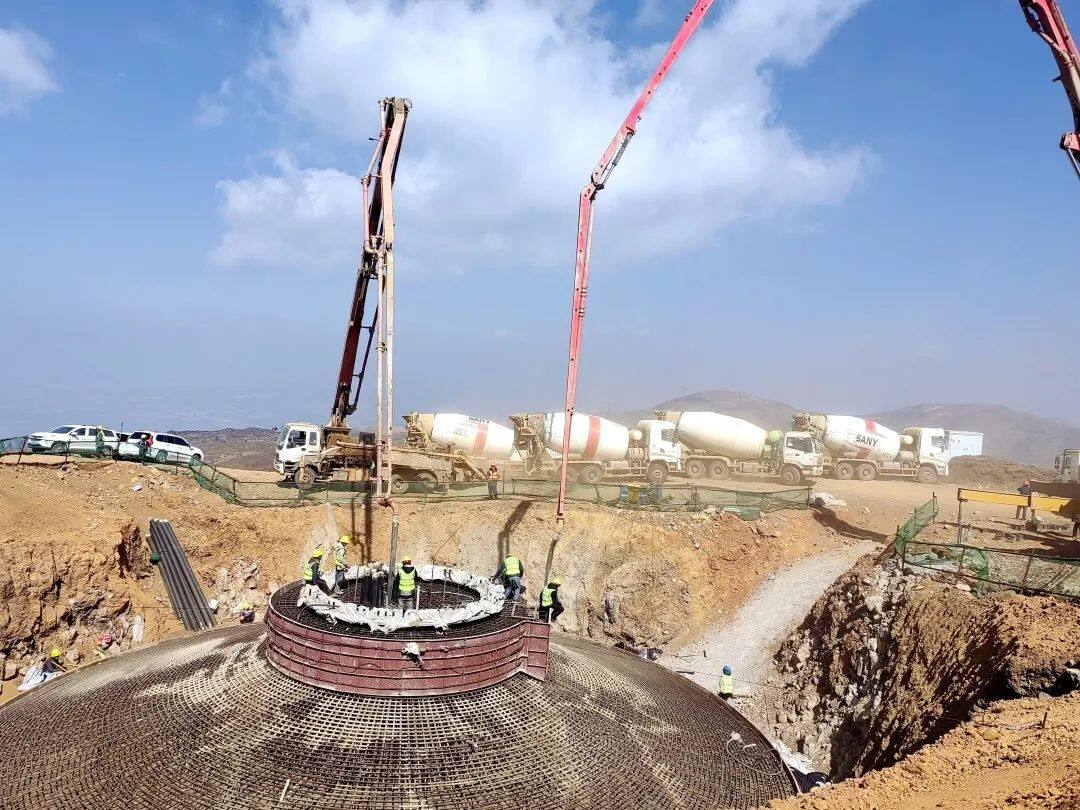

On March 19, 2023, the foundations of 15 wind turbines in the Julongliang Wind Power Project (Phase I) of the Dianzhong New Energy Division of Datang Yunnan Company were completed, making it a plateau mountain wind turbine project with the largest single-unit capacity and the longest impeller diameter in China. The construction of the decisive battle hoisting charge marks an important step in the development of the Dianzhong New Energy Division in new energy projects, energy conservation and emission reduction, and it is also an important manifestation of promoting ecological priority, conservation and intensive, green and low-carbon development.

Create a high-quality plateau wind farm and optimize the power structure of the resident

Julongliang Wind Power Project is located in Xundian County, Kunming City. It is a plateau mountain wind power project with an average altitude of 3,300 meters and an installed capacity of 100MW. This project is one of the key projects in the new energy planning of Yunnan Province to ensure supply and promote investment, and was included in the list of top priority projects in Yunnan Province in 2022. After the project is completed, it is estimated that the annual power generation will be 380 million kwh, and the annual standard coal can be saved 91,100 tons, reducing 245,900 tons of carbon dioxide emissions and 472,800 tons of sulfur dioxide emissions. The project construction not only effectively utilizes local wind energy resources, improves regional power supply capacity, promotes the revitalization of local industries, but also plays a positive role in reducing air pollution. The obvious economic benefits, social benefits and environmental benefits will contribute to the realization of the "double carbon" goal and Yunnan's creation of a strong green energy province.

Comprehensively promote rural revitalization and write a new chapter in green development

The business department has always thoroughly implemented the decisions and deployments of the Party Central Committee, the State Council, the Yunnan Provincial Party Committee and the Provincial Government, actively participated in rural revitalization, helped Xundian County to consolidate and expand the achievements of poverty alleviation and effectively link up with rural revitalization, actively fulfilled social responsibilities, and contributed to Xundian The Red Cross Society of the Hui and Yi Autonomous County donated 1 million yuan, which was organically combined with the needs and capabilities of the social and economic development of Xundian County, turning the resource advantages of the Xundian area into development advantages, and turning the labor skills of the local people into labor value . The business unit has always insisted on doing what is within its capabilities and doing its best to support the improvement of the local living environment, promote the renovation of campus infrastructure, and infrastructure construction related to people's livelihood, such as water and electricity networks, to help the revitalization of Xundian villages.

Overcome difficulties and seize progress, seize the day and night to promote compliance

As the first wind power project approved for construction in Kunming since 2014, it is also the first project approved and started to be constructed by the business department after the Yunnan company's new energy management adjustment and optimization system reform. The business unit has always adhered to the premise of compliance with laws and regulations, and obtained approvals in a timely manner to meet the basic requirements of the country, industry, region, and project model. During this period, the leaders, cadres and employees of the business unit insisted on high-density connection with all parties, took timely and effective measures to solve difficult problems, innovated working methods, and made every effort to promote the preliminary work of the project. The project procedures from land pre-examination to project approval took less than two and a half months. Successfully obtained approvals for soil and water conservation, forest land, temporary land use, grid connection, etc., demonstrating the speed of Datang among similar projects.

Race against time to ensure energy supply and safe construction against wind and snow

Since the start of construction on September 23, 2022, faced with the influence of uncertain factors such as repeated epidemics, plateaus and high cold, and winter construction, the business department has always adhered to the principle of "Where the hard work is carried out, the party organization will be established" and the project The actual construction work is organically combined with the "Party Party Vanguard", "Youth Commando", and "Engineering Construction Demonstration Post". In 2019, the foundation pouring of the first fan of the Julongliang Wind Power Project was completed; the relevant person in charge of the business department was stationed on the front line of the construction for more than three months, commanding and serving at the front, coordinating and solving problems such as large-scale transportation and fan hoisting on site, and the cadres and staff of the project department Take the initiative to give up holidays and rest, carefully study the characteristics of the terrain, pay close attention to the complex and changeable weather in the mountains on site, communicate and coordinate with the participating parties in a timely manner, and hold special meetings to conduct in-depth discussions on material supply, hoisting technical measures, safety risk management and control, emergency plans, etc. , the hoisting of the first wind turbine was completed on December 20, 2022; the business department actively coordinated with the participating units, cooperated with all parties to improve their positions, highlight the overall situation, work in the same direction, work together, and strictly control the safety and quality of the project Close, detail and break down the project production schedule plan, fully promote the efficient docking of various construction links, and accurately implement each construction plan. The project will realize the first power generation on December 31, 2022; on March 19, 2023, 15 wind turbines of the project The foundations are all poured.

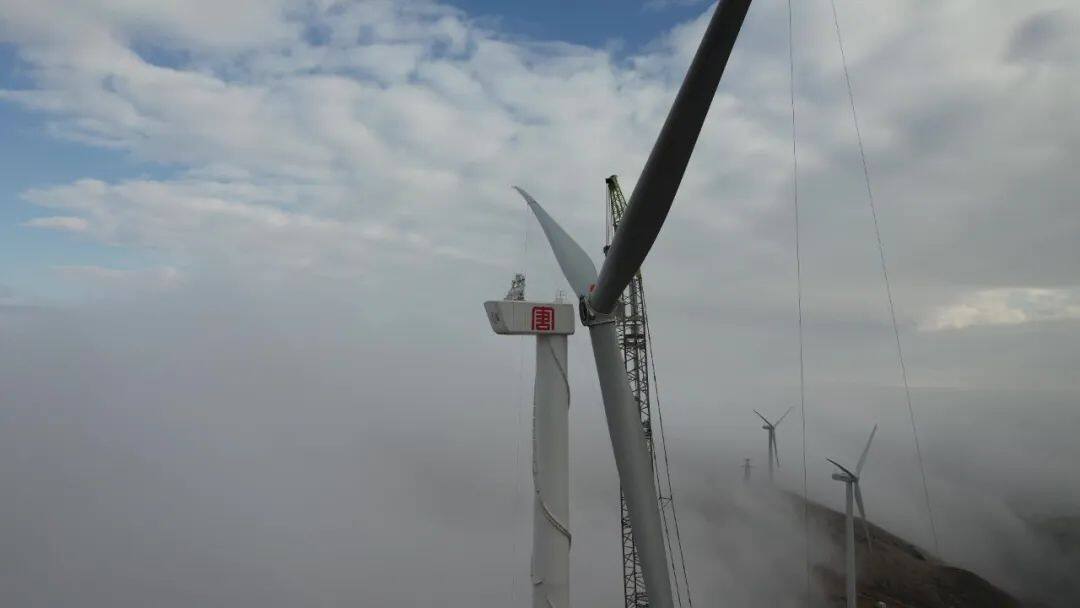

After more than 170 days of hard work, all cadres and employees of Dianzhong New Energy Division always kept their responsibilities and missions in mind, fighting against ice and snow, fighting severe cold, preventing epidemics, promoting compliance, solving problems, ensuring grid connection, and making every effort to promote the progress of project construction. In the final sprint period of the decisive battle, the business department will continue to adhere to the general tone of safety first, seeking progress while maintaining stability, highlighting key points, ensuring production, doing everything possible, and being able to work as quickly as possible. Do a good job in the follow-up fan hoisting, supporting equipment installation and grid connection coordination, etc., to ensure that the project construction will be completed as expected, unswervingly promote the rapid and high-quality development of the new energy industry of Yunnan Company, and use practical actions to build the best in China and the first-class in the world for the group company Energy suppliers contribute. Editor / Zhao E


Comment

Related articles

Wind power

Chongqing 360MW wind power energy storage project approved

04-25

Wind power

Hainan 24.9 million kW offshore wind farm project planning EIA publicity

04-25

Wind power

6GW! Australia will launch a tender for large-scale renewable energy projects

04-25

Wind power

Two wind power projects in Chongqing have been approved

04-24

Wind power

Datang Suihua Qing'an Phase I 300MW wind power project was approved

04-24

Wind power

Jiangsu Province wind power intelligent manufacturing project officially started

04-23

Collect
Comment
Share

Retrieve password

Get verification code
Sure
